Pepper Pike, Ohio

Bathroom remodeling in Pepper Pike

Many Shaker Boulevard colonials already carry an addition, so a Pepper Pike bath that grows the house again is a new volume that has to read as the same house. That is why ABR, on a first or third Friday, sits in front of the permit.

Finished bathroom with large-format wall tile to the ceiling and a tiled floor.
Finished bathroom: wall tile to the ceiling, matching floor, June 2026

A mid-century colonial on Shaker Boulevard often has an addition on it already. A bath that stays inside the envelope, a wet wall, a pan, a valve, a fan, can skip the architectural board, ABR. A bath that adds or enlarges a window on the street elevation, or pushes the room outward, cannot: the bump-out is another addition, and additions here almost always see the board. ABR typically sits the first and third Fridays, and its approval is not a building permit.

Before the plumbing permit there is registration. Pepper Pike is a separate registration with its own paper, and it clears before the permit is pulled; inspection requests afterward are phone or email, so the schedule has a person on it, not a portal button. Roman Ivakhnenko writes the bath as separate lines: the membrane or pan and its slope, the valve, the fan and where it terminates, the tile, and each hold. The contract carries one name, NIR Solutions LLC.

The photographs on this page are from our own jobs on Cleveland’s east side. Each caption says what is in the frame and when. None is presented as work in Pepper Pike.

The permit path in Pepper Pike

  1. Register with the cityNIR’s registration is Orange Village Contractor Registration #4235, General, through December 31, 2026; Pepper Pike is a separate registration. It starts in Citizenserve and finishes on paper: an original signed $25,000 surety bond and an original certificate of insurance naming the City of Pepper Pike. A fax or a photocopy is turned away.
  2. Settle which job this is before a demolition date existsA fixture that leaves its rough-in, or a wet wall that comes open, is a plumbing permit and usually an electrical one. Tile over tile with nothing moved may not be. Roman settles which of the two this bath is with the city’s building department first; the demolition date is written after that answer.
  3. ABR, only if the envelope changesKeep the walls and windows where they are and this step disappears. A new street-elevation window or a bump-out goes to the board first, typically a first or third Friday; a rear bump-out near a watercourse also answers to the city’s riparian setbacks map. Board approval is not a building permit.
  4. Permit, then holds by phone or emailThe plans are checked, then the plumbing and electrical permits issue. Fees are paid by phone, mail, or in person, and the permit expires if work has not started within six months. Inspection requests are also phone or email: in-wall plumbing, rough electrical, a pan check if the city asks, and a final. No tile until the hold in front of it is signed.

Registration, the board if the envelope changes, the permit with its start window, and every hold are separate lines on the estimate.

What Pepper Pike houses do to a bathroom estimate

Pepper Pike houses are larger than most in the valley: mid-century colonials along Shaker Boulevard and bigger houses on estate lots. Many of the colonials already carry an addition, so the next volume has to read as the same house, and that is why the board sits in front of the permit. Inside, the addition and the original house are two framing dates, and a primary bath that sits across that seam has its waste and vent path drawn before the estimate is priced.

Basements here are drier than in the river villages, but not dry; grade and downspouts make the moisture line, so a waste line that drops through the basement is confirmed against what is down there before the ceiling is opened. Windows are the other Pepper Pike question. A bath window on a street elevation is a board item the moment it changes, and the mistake is calling the rear of the house not visible; the board decides visibility. If the window moves, the Friday board is a phase before the permit, not a risk discovered after demolition.

One bathroom, cement board to grout

Five photographs from a single bathroom, in order: the backer board, the waterproofing membrane, the tile layout, the tile set, the grout.

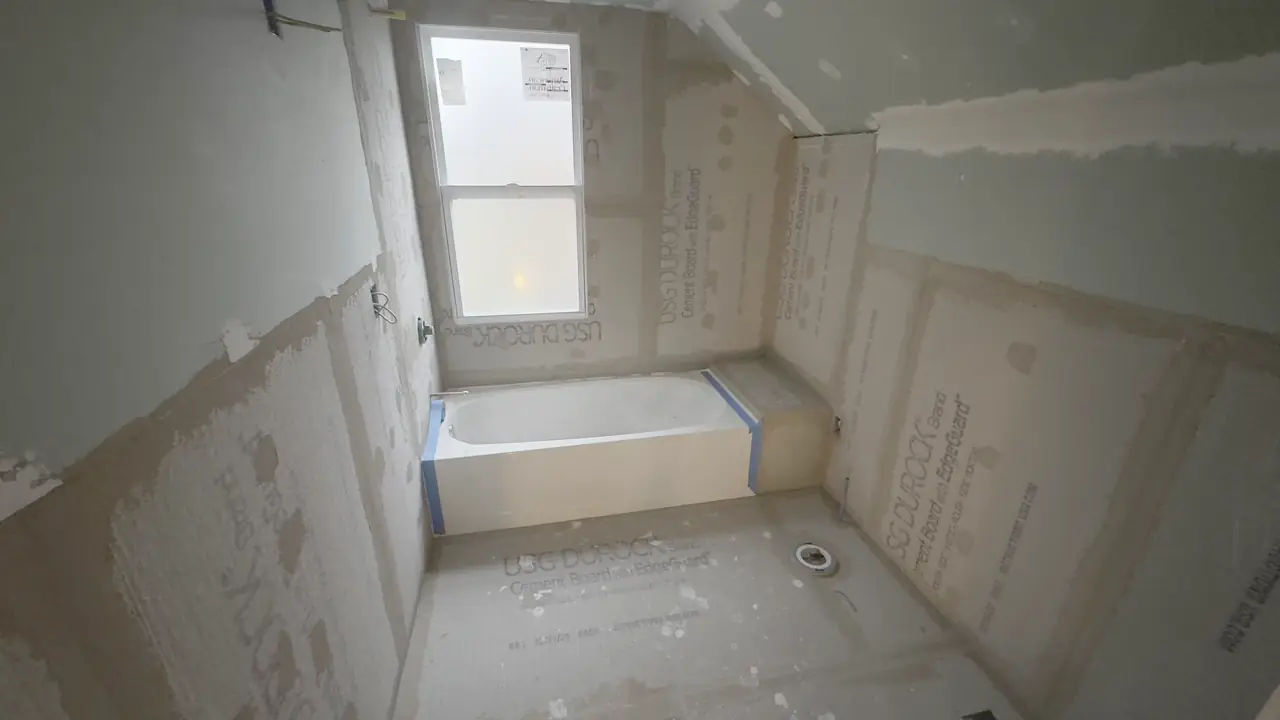

  1. Cement board walls around a tub, before waterproofing.
    01 / 05Cement board walls around a tub before waterproofing, April 2026
  2. Tub surround and floor coated in red liquid waterproofing membrane before tile.
    02 / 05Tub surround and floor coated with waterproofing membrane before tile, April 2026
  3. Plank tile laid out on red membrane with spacers, tub at the back.
    03 / 05Floor tile laid out on membrane with spacers, April 2026
  4. Plank floor tile set with orange spacers, tub in place, walls still red membrane.
    04 / 05Plank tile set with spacers, tub in place, April 2026

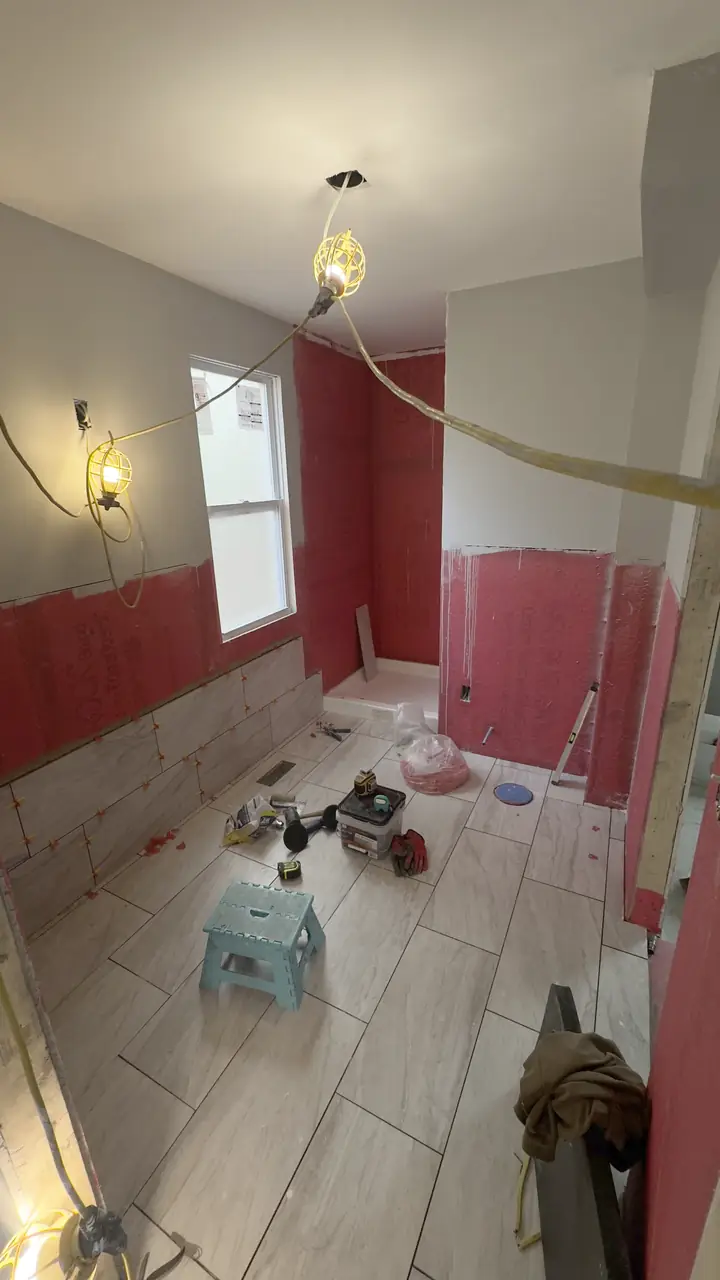

  5. Bathroom floor tile grouted, wall tile partly set around the tub.
    05 / 05Floor tile grouted, wall tile in progress, April 2026

Questions from Pepper Pike

Does a bathroom remodel in Pepper Pike go before the architectural board?

Not when it stays inside the envelope; fixtures, pan, tile, and a moved toilet are not board items. A window added or enlarged on a street elevation is, and so is a bump-out. In Pepper Pike the board is a phase on the schedule, typically a first or third Friday, and its approval is not the permit.

How long is a Pepper Pike bathroom permit good for?

It expires if work has not started within six months. For a bath, selections drive the start: allowances for the pan, valve, and fan stay allowances until they are chosen, and an owner-supplied fixture that shows up without its valve, trim, or drain kit is not installed as a half kit.

Can NIR register in Pepper Pike the same day the bond arrives?

Not as a promise. Intake windows are 8:00 to 11:30 a.m. and 12:30 to 3:00 p.m., and the city wants the original signed $25,000 surety bond and the original certificate of insurance in hand, not faxed. An original that arrives at 3:10 p.m. waits until tomorrow. So the registration line on the estimate carries a date range, not a same-day claim.

Does a rear bump-out for a Pepper Pike bath have to clear the riparian map?

If the lot is near a watercourse, yes. The city publishes a riparian setbacks map, and a rear addition that looks clear on a napkin can fail it. So a bump-out that even approaches a watercourse gets a survey line before drawings; paying for that line first is cheaper than redrawing after ABR.

Request an estimate in Pepper Pike

Four minutes. Rooms, budget range, and when you want to start. We reply with a site-visit time, not a number.

The number reaches Roman Ivakhnenko, who writes every estimate. Texts get a reply with a site-visit time.

Estimate request

Orange Village Contractor Registration #4235


Twenty words is enough. City, rooms, and what is wrong.

No trackers on this sheet. A draft stays in this browser until you send it. Ohio Revised Code 4722 on jobs over $25,000: written contract, 10% down cap.
