Home additions in Solon
In Solon the board that reviews an addition's elevation is often the subdivision's, not the city's. Where covenants run the street, that board keeps its own calendar beside a permit review of 7 to 10 business days.

An addition in Solon adds volume to a house built to a plan, and often to a covenant. The city checks setbacks, lot coverage, and height against the footprint you want, then reviews the application in roughly 7 to 10 business days. Where the subdivision has a board, that approval is separate paper on a separate schedule, and it can refuse a color the city already stamped.
Roman writes both dates before anyone names an excavation week. The estimate then splits the way the work splits: site, foundation, structure, envelope, and the rooms inside. One line reading room addition is how a number moves without anyone noticing. The junction with the existing house carries its own items, because that is where the roof ties in, the flashing runs, and the old wall opens.

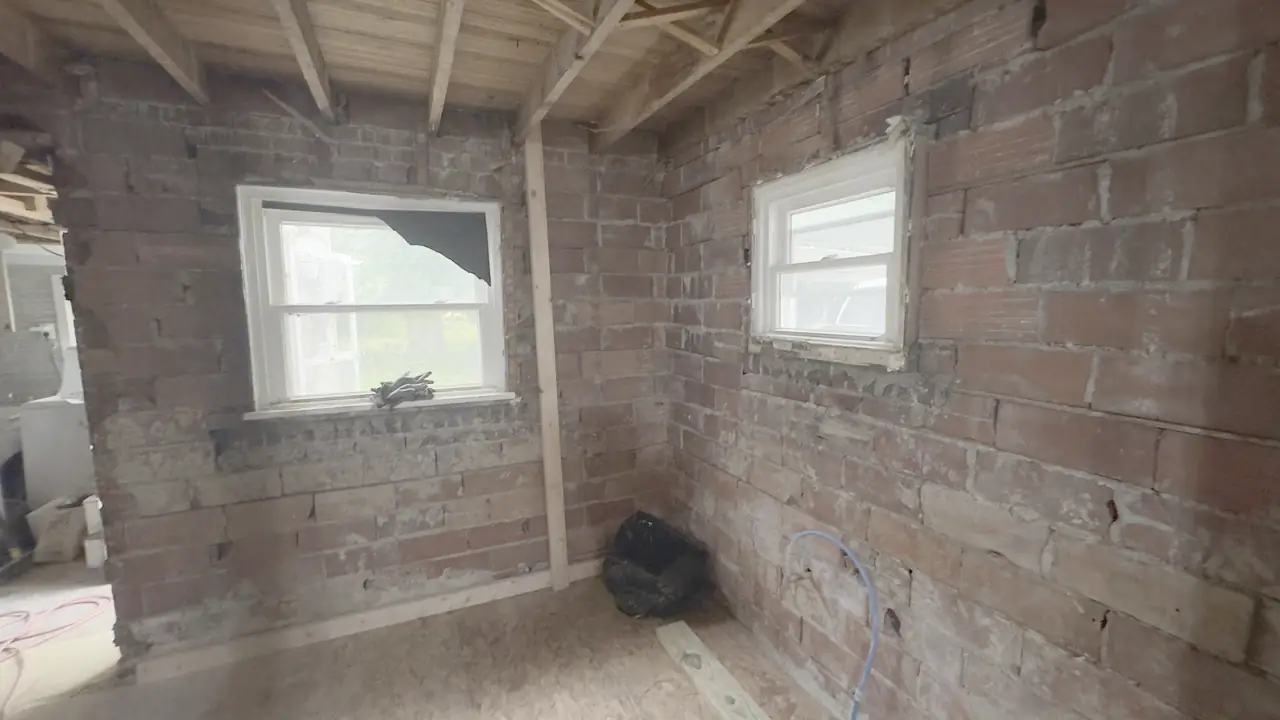

The photographs on this page are from our own jobs on Cleveland’s east side. Each caption says what is in the frame and when. None is presented as work in Solon.
The permit path in Solon
- Register, then list the subsSolon registers contractors first: a $100 fee, a sealed $25,000 registration bond, and insurance naming the City as additional insured at $1,000,000 each occurrence and $2,000,000 aggregate. NIR Solutions carries $1,000,000 general liability with contractors errors and omissions, and that certificate is attached to the contract.
- Zoning before anything is drawn twiceSetbacks, lot coverage, and height get measured against the footprint you actually want. On a shallow rear yard that check decides whether the addition goes back, up, or nowhere. A drawing that answers zoning first survives review; one that guesses at it comes back with the clock restarted.
- Two approvals, two calendarsWhere the subdivision has a board, its submittal runs beside the city's rather than after it. A city stamp does not carry the association, and an association stamp does not pull a permit. We file both, and the later of the two sets the excavation date.
- Apply, then work the inspection listApplications go to Permit@Solonohio.org and review typically runs 7 to 10 business days. An addition is not one of the simplified forms. After issue, the holds are footing, foundation, rough trades, framing, insulation, and final, with a certificate where the city issues one.
A plumber added after the application is filed delays the permit, not just the plumbing.
What Solon houses do to a home addition estimate
The stock is 1970s and later, production and custom, gypsum board rather than plaster on lath, attached garages, covenants on the elevations. Framing is predictable; matching is not. Siding and window packages age in parallel across a street, so the profile on the wall being extended may no longer be sold. Matching can mean re-siding a whole face instead of patching twenty feet, and that call belongs on the estimate before the wall opens.
Basements move the foundation line. Many were finished by an earlier owner, sometimes without a permit, and a new footing still has to step against that wall. We price what can be seen and name a condition as a condition rather than finding it in week two. Lots here usually hold the footprint, so cost lands on drainage away from the new foundation and truck access past a finished yard.
Questions from Solon
Does the subdivision board sign off before Solon issues the permit?
Not necessarily, and the two are not ranked. The city reviews zoning and code. The board reviews what the street sees. Either can come first, and neither replaces the other. A permit in hand does not settle a covenant argument about siding color or roof pitch, so we file both packages and put both dates on one schedule.
Can an addition go on one of the simplified applications?
No. Those forms cover reroof, siding, windows, doors, and furnace or air conditioning replacement. New volume is a full building permit with drawings, zoning review, and the whole inspection sequence. Painting, wallpaper, and same-size floor covering typically need no permit, which helps only when interior finish is being scoped.
What blows the 7 to 10 business day review in Solon?
Usually a trade that was not registered when the application went in, or a drawing that answers the covenant instead of the setback. Every subcontractor listed has to be registered before the permit issues, so we collect those certificates while the drawings are still being finished rather than after the file is open.
The basement was finished before we bought the house. Does that stop an addition?
It does not stop it, and it does not become ours. Our permit describes our work, and inspections cover that work. What matters is structural: whether the new footing can step against that wall, what sits behind the finish where the opening goes, and whether a mechanical run has to move. We look during the site measure and price it in writing before demolition.
Home additions nearby
Other work in Solon
Request an estimate in Solon
Four minutes. Rooms, budget range, and when you want to start. We reply with a site-visit time, not a number.
The number reaches Roman Ivakhnenko, who writes every estimate. Texts get a reply with a site-visit time.
